16 November 1973 14:01 GMT. Landing Date: 1974-02-08 15:16:31. Flight Time: 84.05 days. Flight Up: Skylab 4. Flight Back: Skylab 4. Call Sign: Skylab. Crew: Carr, Gibson Edward, Pogue. Backup Crew: Brand, Lenoir, Lind. Location of Capsule: National Air and Space Museum (Smithsonian Institution), Washington, DC. Program: Skylab. Of note: Record flight duration. What went wrong: Rebellion by crew against NASA Ground Control overtasking led to none of the crew ever flying again. Final Skylab mission; included observation and photography of Comet Kohoutek among numerous experiments. Completed 1,214 Earth orbits and four EVAs totalling 22 hours, 13 minutes. Increased manned space flight time record by 50%. Rebellion by crew against NASA Ground Control overtasking led to none of the crew ever flying again. Biological experiments included two Mummichog fish (Fundulus heteroclitus). The space vehicle consisted of a modified Apollo CSM and a Saturn IB launch vehicle. All launch phase events were normal, and the CSM was inserted into a 150.1- by 227.08-km orbit. The rendezvous sequence was performed according to the anticipated timeline. Stationkeeping was initiated about seven and one-half hours after liftoff, and hard docking was achieved about 30 minutes later following two unsuccessful docking attempts. Planned duration of the mission was 56 days, with the option of extending it to a maximum of 84 days.
SKYLAB STATISTICAL SUMMARY
ORBITAL
PARAMETERS 268.1 x 269.5 Miles
ORBITAL
INCLINATION 50 Degrees
ORBITAL
PERIOD APP. 93 MINUTES
DISTANCE/
ORBIT 26,575 MILES
DISTANCE
TRAVELED/Miles SL-2 SL-3 SL-4 TOTALS
(MANNED) 11.5 Million 24.5 Million 34.5 Million 70.5 Million Miles
MISSION
DURATION 28 DAYS 59 DAYS 84 DAYS 171 DAYS
49 MIN 11 HRS 9 MIN 01 HR 16 MIN 13 HRS 14 MIN
NUMBER
OF
REVOLUTIONS
(MANNED) 404 858 1214 2476
______________________________________________________________________
Skylab-4 MANHOUR UTILIZATION
MEDICAL ACTIVITIES 366.7 " 6.1 "
SOLAR OBSERVATIONS 519.0 " 8.5 "
EARTH RESOURCES 274.5 " 4.5 "
OTHER EXPERIMENTS 403.0 " 6.7 "
SLEEP, REST & OFF
DUTY 1846.5 " 30.5 "
PRE/POST SLEEP &
EATING 1384.0 " 23.0 "
HOUSEKEEPING 298.9 " 4.9 "
PHYSICAL TRAINING
& PERSONAL HYGIENE 384.5 " 6.4 "
OTHER (EVA) ETC 571.4 " 9.4 "
TOTAL: 6048.5 " 100 "
Skylab TOTALS FOR SL-2, SL-3 AND SL-4
MEDICAL ACTIVITIES 824.5 " 6.9 "
SOLAR RESOURCES 941.3 " 7.9 "
EARTH RESOURCES 569.4 " 4.8 "
OTHER EXPERIMENTS 712.0 " 6.0 "
SLEEP, REST & OFF
DUTY 3746.6 " 31.5 "
PRE/POST SLEEP &
EATING 2836.8 " 23.8 "
HOUSEKEEPING 560.9 " 4.7 "
PHYSICAL TRAINING
& PERSONAL HYGIENE 642.9 " 5.4 "
OTHER (EVA) ETC 1083.6 " 9.0 "
TOTAL: 11918.0 " 100 "
======================================================================
EXPERIMENT PERFORMANCE
SL-2 SL-3 SL-4 TOTALS
HOURS % HOURS % HOURS % HOURS %
SOLAR ASTRONOMY 117.2 29.9 305.1 28.2 519.0 33.2 941.3 31.0
EARTH OBSERVATIONS 71.4 18.2 223.5 20.6 274.5 17.6 569.4 18.8
STUDENT 3.7 0.9 10.8 1.0 14.8 0.9 29.3 0.9
ASTROPHYSICS 36.6 9.4 103.8 9.6 133.8 8.5 274.2 9.0
MAN/SYSTEMS 12.1 3.1 117.4 10.8 83.0 5.3 212.5 7.0
MATERIALS SCIENCE 5.9 1.5 8.4 0.8 15.4 1.0 29.7 1.0
LIFE SCIENCE 145.3 37.0 312.5 29.0 366.7 23.5 824.5 27.2
KOHOUTEK ----- ---- ----- ---- 156.0 10.0 156.0 5.1
TOTALS 392.2 100 1081.5 100 1563.2 100 3036.9 100
======================================================================
EXTRAVEHICULAR ACTIVITIES
SL-2 SL-3 SL-4
STAND UP EVA 05-25-73
33 MIN
EVA 1 06-07-73 08-06-73 11-22-73
4 HRS 10 MIN 6 HRS 31 MIN 6 HRS 33 MIN
EVA 2 06-19-73 08-24-73 12-25-73
1 HR 37 MIN 4 HRS 30 MIN 6 HRS 51 MIN
EVA 3 09-22-73 12-29-73
2 HRS 42 MIN 3 HRS 30 MIN
EVA 4 02-03-74
5 HRS 19 MIN
TOTALS: 6 HRS 20 MIN 13 HRS 43 MIN 22 HRS 13 MIN
TOTAL TIME: 41 HRS 22 MIN
======================================================================
DATE RETURNED
SL-2 SL-3 SL-4 TOTALS
SOLAR OBSERVATIONS 28739 FRAMES 74942 FRMS 73366 FRMS 177047 FRMS
EARTH OBSERVATIONS
FILM 9846 FRAMES 16800 FRMS 19400 FRMS 46146 FRMS
MAGNETIC TAPE 45000 FT 93600 FT 100000 FT 238600 FT
======================================================================
SKYLAB SUMMARY (CONCLUDED)
EXPERIMENT SUMMARY PLANNED ACTUAL PERCENT DEVIATION
Earth Observation Passes 62 99 + 60 %
Solar Viewing Time 566 hrs 724.7 hrs + 27.5 %
Manned Solar Viewing Time 879.5 hrs 941.3 hrs + 7.1 %
Biomedical Investigations 701 922 + 32 %
Engineering/Tech Inves. 264 245 - 3.4 %
Materials/Space Manuf. Inves. 10 32 +220 %
Astrophysics Investigations 168 345 +105 %
Student Exp. Investigations 44 52 + 18 %
Science Demonstrations 26 11 - 42 %
(OPTIONAL SL-4 ONLY)
CONSUMABLE UTILIZATION
LAUNCH END OF MISSION CONSUMABLES USED
Water 6000 LBS 1710 LBS 4290 LBS
Oxygen 6100 LBS 2764 LBS 3336 LBS
Nitrogen 1540 LBS 607 LBS 933 LBS
TACS 80000 LBS-SEC 12488 LBS 67512 LBS-SEC
Note: over 12% of the TACS were used during the first 10 days of the
mission
Skylab 4 Chronology - - 1973 August 7-15 - Viewing program for the comet Kohoutek during the SL-4 mission.
Representatives from NASA Hq, MSFC, GSFC, and JSC attended. Results of a feasibility study for viewing the comet were presented to the NASA Administrator on 15 August. It was agreed that observations of Kohoutek would he made at appropriate times during the SL-4 mission.
- - 1973 August 14 - November 16 - Skylab 4 space vehicle moved to Launch Complex 39B in readiness for rescue mission.
The space vehicle consisted of a Saturn IB launch vehicle-S-IB-208 first stage, S-IVB-208 second stage, and S-IU-207 instrument unit; a CSM-118; and a spacecraft lunar module adapter. The SL 4 crew was made up of commander Gerald P. Carr, science pilot Edward G. Gibson, ...more...
- 1973 Sep 6 - Eye protection not for Kohoutek operations.
At a Kohoutek status meeting, JSC w as requested to determine if additional ultraviolet eye protection would be required by the Skylab 4 astronaut while performing Kohoutek operations. A study indicated that no additional eye protective devices would be required for either intra- or extravehicular viewing of the comet. The use of the existing space suit sun visors would be required during extravehicular viewing.
- - 1973 October 30 - November 6 - Two vials, each containing 500 gypsy moth eggs, were hand carried to JSC from the Department of Agriculture.
After being loaded in flight containers, they were hand carried to KSC. The eggs would be launched on Skylab 4 and then transferred to the OWS sleep compartment area where they would be monitored during the course of the SL-4 mission. The eggs were being carried at the request of the Secretary of Agriculture.
- 1973 Nov 6 - A high-energy food bar was added to the menu of the Skylab 4 astronauts.
The 72 kg of additional food placed aboard the SL-4 command module included 39 kg of high-energy food bars and would supply sufficient food for an extension of the mission to 85 days, plus an additional 10 days' supply for a rescue capability. The food bars, which contained 300 calories each, would be used by the crewmen every ...more...
- 1973 Nov 6 - Skylab 4 delayed to replace cracked fins on the S-IB.
A shift in the Skylab 4 launch schedule was required in order to replace eight cracked fins on the S-IB. The hairline cracks were discovered during a postcountdown demonstration test inspection. Initial indications were that the 14 cracks were caused by load stress or salt air, or possibly a combination of both.
- 1973 Nov 14 - A launch readiness review was held at KSC. From the review and closeout of action items, the Skylab 4 vehicle was determined to be ready for launch on 16 November 1973.
Other reviews included the KSC flight readiness review, 18 October; the JSC Director's flight readiness review and the JSC command and service module flight readiness review, 11 October; the MSFC review of the Skylab Workshop systems capabilities, 17 September; and the KSC SL-4 launch readiness review, 15 October 1973.

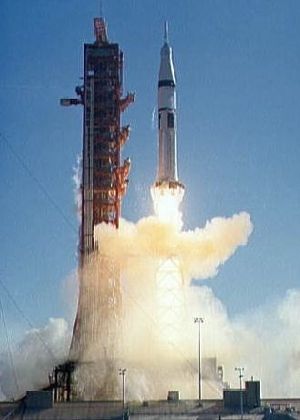

- 1973 Nov 16 - Skylab 4 Crew: Carr, Gibson Edward, Pogue. Spacecraft: Apollo CSM. Payload: Apollo CSM 118. Mass: 20,847 kg (45,959 lb). Launch Site: Cape Canaveral. Launch Vehicle: Saturn IB. Duration: 84.05 days. Perigee: 422 km (262 mi). Apogee: 437 km (271 mi). Inclination: 50.00 deg. Period: 93.10 min.
Final Skylab mission; included observation and photography of Comet Kohoutek among numerous experiments. Completed 1,214 Earth orbits and four EVAs totalling 22 hours, 13 minutes. Increased manned space flight time record by 50%. Rebellion by crew against NASA Ground Control overtasking led to none of the crew ever flying again. Biological experiments included two Mummichog fish (Fundulus heteroclitus). The space vehicle consisted of a modified Apollo CSM and a Saturn IB launch vehicle. All launch phase events were normal, and the CSM was inserted into a 150.1- by 227.08-km orbit. The rendezvous sequence was performed according to the anticipated timeline. Stationkeeping was initiated about seven and one-half hours after liftoff, and hard docking was achieved about 30 minutes later following two unsuccessful docking attempts. Planned duration of the mission was 56 days, with the option of extending it to a maximum of 84 days.
- - 1973 November 17 - February 7 - Skylab Orbital Workshop activation by the crew of Skylab 4. Spacecraft: Skylab, Apollo ATM.
The reactivation included the reservicing of the airlock module primary coolant loop. The commander and pilot experienced symptoms resembling motion sickness during the initial three days of the visit, and flight plan activities were adjusted accordingly. Crew health was good thereafter. The medical experiments conducted during the first and second visits were continued ...more...
- 1974 Jan 15 - Series of engineering tests on the Orbital Workshop authorized following completion of the Skylab 4 mission.
A series of engineering tests on the Orbital Workshop was authorized following completion of the Skylab 4 mission provided that only tests which would result in significant engineering knowledge would be performed. A series of engineering tests on the Orbital Workshop was authorized following completion ...more...
- - 1974 July - Comet Kohoutek and Skylab
A JSC report summarized Comet Kohoutek's relationship to Skylab operations: Comet Kohoutek was discovered on 7 March 1973, three months before the launch of Skylab. Preliminary feasibility studies indicated that there was insufficient time to send a suitably instrumented spacecraft to observe and study the comet at close range. However, other manned and unmanned observations were planned, with the most significant to occur during the third visit to the orbiting Skylab. Unique scientific data were obtained by the third-visit crew, helping to make Kohoutek the most comprehensively studied comet in history. Because of the flexibility and adaptability of the manned program, changes were ...more...
Bibliography and Further Reading - Wilson, Keith T., Spaceflight, "EVA Log 1965-1997", 1998, Volume 40, page 85.
- Turnill, Reginald,, The Observer's Spaceflight Directory, Frederick Warne, London, 1978. ISBN: 0723220514. Good miniature encyclopaedia of space programs just before the shuttle started flying. More at amazon.com...
- McDowell, Jonathan, Jonathan's Space Home Page, Harvard University, 1997-present. Jonathan McDowell's complete on-line listing of all objects orbited and over 20,000 rocket launches Accessed at: http://www.planet4589.org/jsr.html.
- Furniss, Tim, Manned Spaceflight Log, Jane's, London, 1986. ISBN: 0710604025. Summary of all manned spaceflights up to 1986. Pre-Glasnost, so many 'war stories' of Soviet manned spaceflight are not included. More at amazon.com...
|
